Reclaimed Water Master Plan Implementation

Project Information
In support of its goal to use its reclaimed water efficiently in its highest and best use, the City of Peoria has begun several projects which will expand its reclaimed water system and provide opportunities for further expansions of the system. This website is dedicated to keeping all interested parties updated on the projects summarized below, and to providing a conduit for communication with City staff regarding questions or comments on those projects during design and construction.

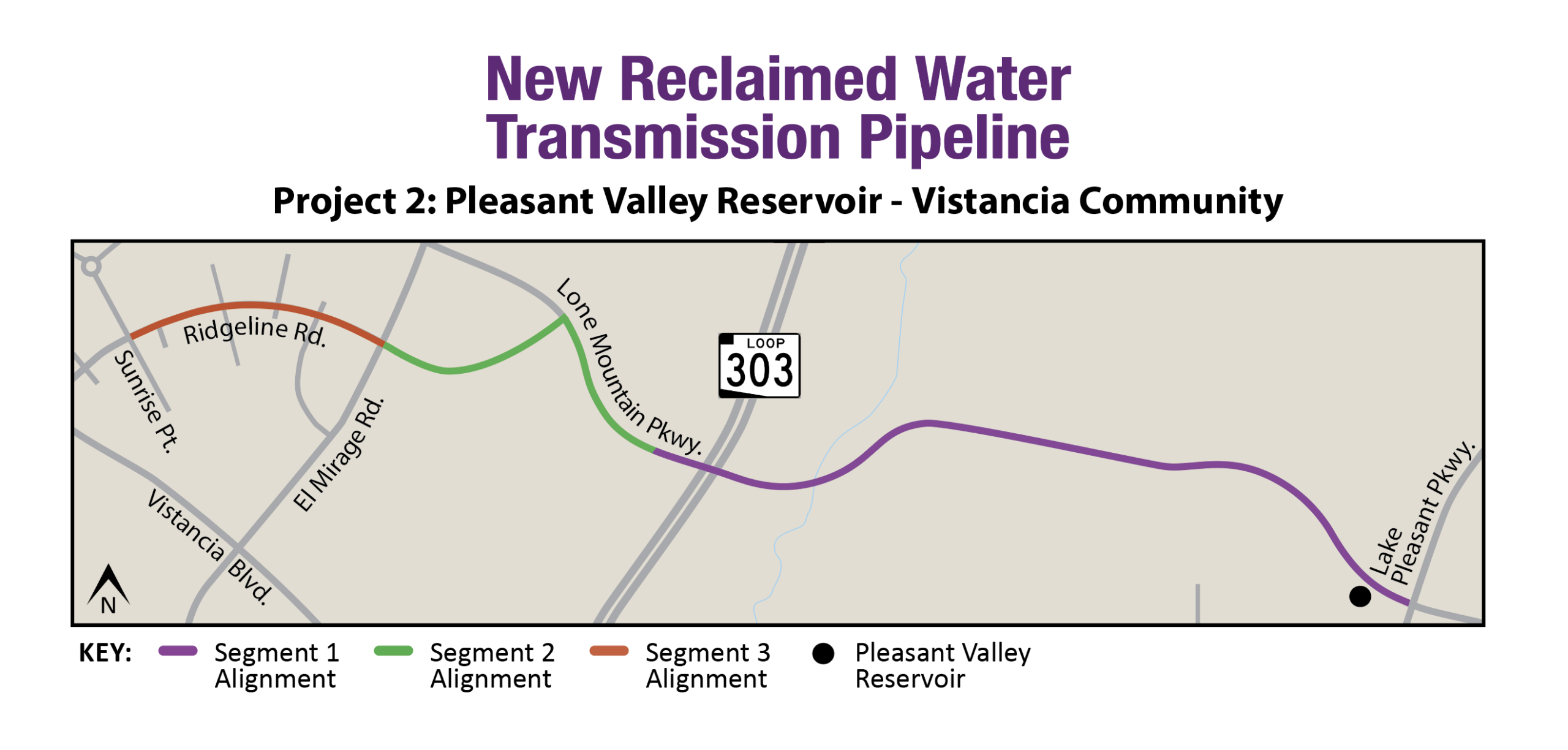

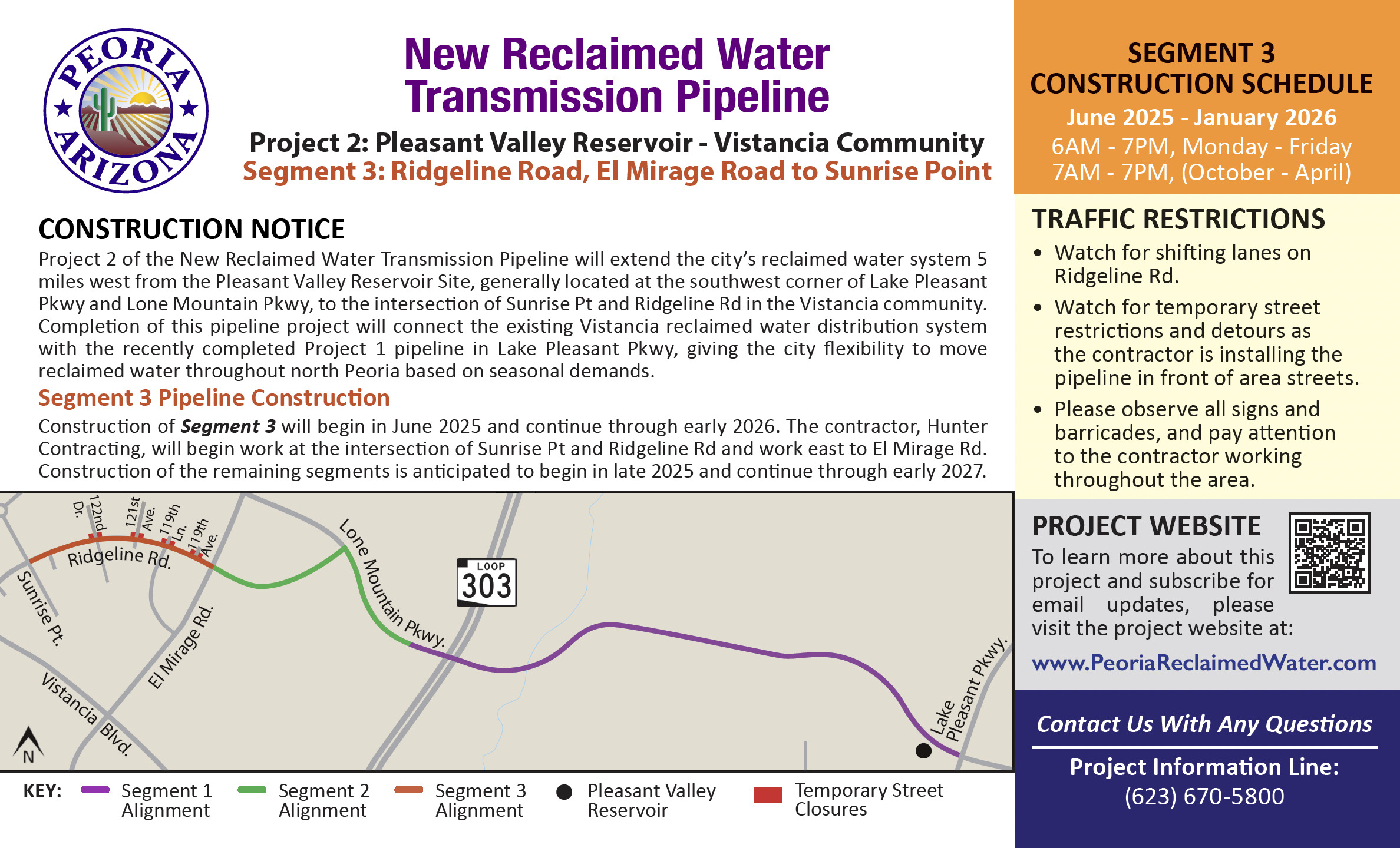

Reclaimed Water Pipeline – Project 2
Project 2 of the New Reclaimed Water Transmission Pipeline will extend the city’s reclaimed water system 5 miles west from the Pleasant Valley Reservoir Site, generally located at the southwest corner of Lake Pleasant Parkway and Lone Mountain Parkway, to the intersection of Sunrise Point and Ridgeline Road in the Vistancia community. Completion of this pipeline project will connect the existing Vistancia reclaimed water distribution system with the recently completed Project 1 pipeline in Lake Pleasant Parkway, giving the city flexibility to move reclaimed water throughout north Peoria based on seasonal demands.
Construction of Segment 3 will begin in June 2025 and continue through early 2026. Construction of Segment 2 will begin in October 2025 and continue through spring 2026. Construction of the remaining segment will begin in 2026.

Reclaimed Water Pipeline – Project 1
As the first in a series of planned reclaimed water expansion projects, Project 1 extended a reclaimed water system 7.6 miles north from the Beardsley Water Reclamation Facility (WRF) for landscape irrigation and lake feature use, including use at the City’s new Paloma Community Park.
The intent of this first project was to provide a reclaimed system backbone to prepare for future growth in the northern extents of the city, enhancing the City’s ability to gain beneficial use of all reclaimed water produced and contributing to Peoria’s sustainable future.
Construction of the City’s reclaimed pipeline was completed in four segments for expedited delivery. Segment 1, shown in yellow, was constructed first, beginning in late 2021. The construction of the other three segments was completed in summer 2024.

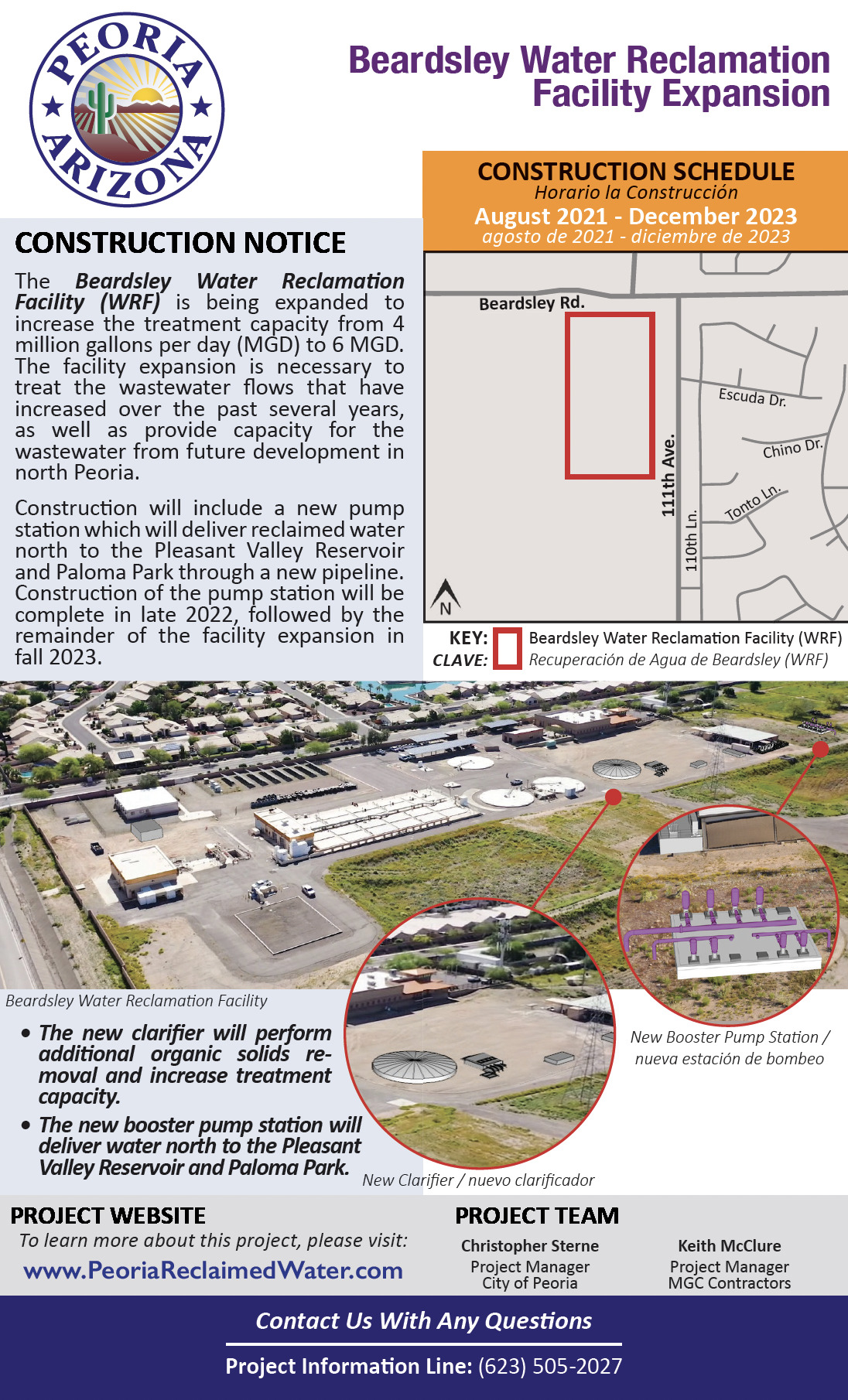

Beardsley WRF Expansion
The Beardsley WRF is being expanded to increase the treatment capacity from 4 to 6 million gallons per day (MGD). The facility expansion is necessary to treat the wastewater flows that have increased over the past several years, as well as provide capacity for wastewater from future development in north Peoria. The project includes the construction of a new pump station, which will deliver reclaimed water to the Pleasant Valley Reservoir through the new Project 1 pipeline.
Construction of the Beardsley WRF Expansion will begin in August 2021 with anticipated completion in Summer 2025.
If you have concerns about odor at your property, please contact the project team at
(623) 505-2027 or info@peoriareclaimedwater.com.

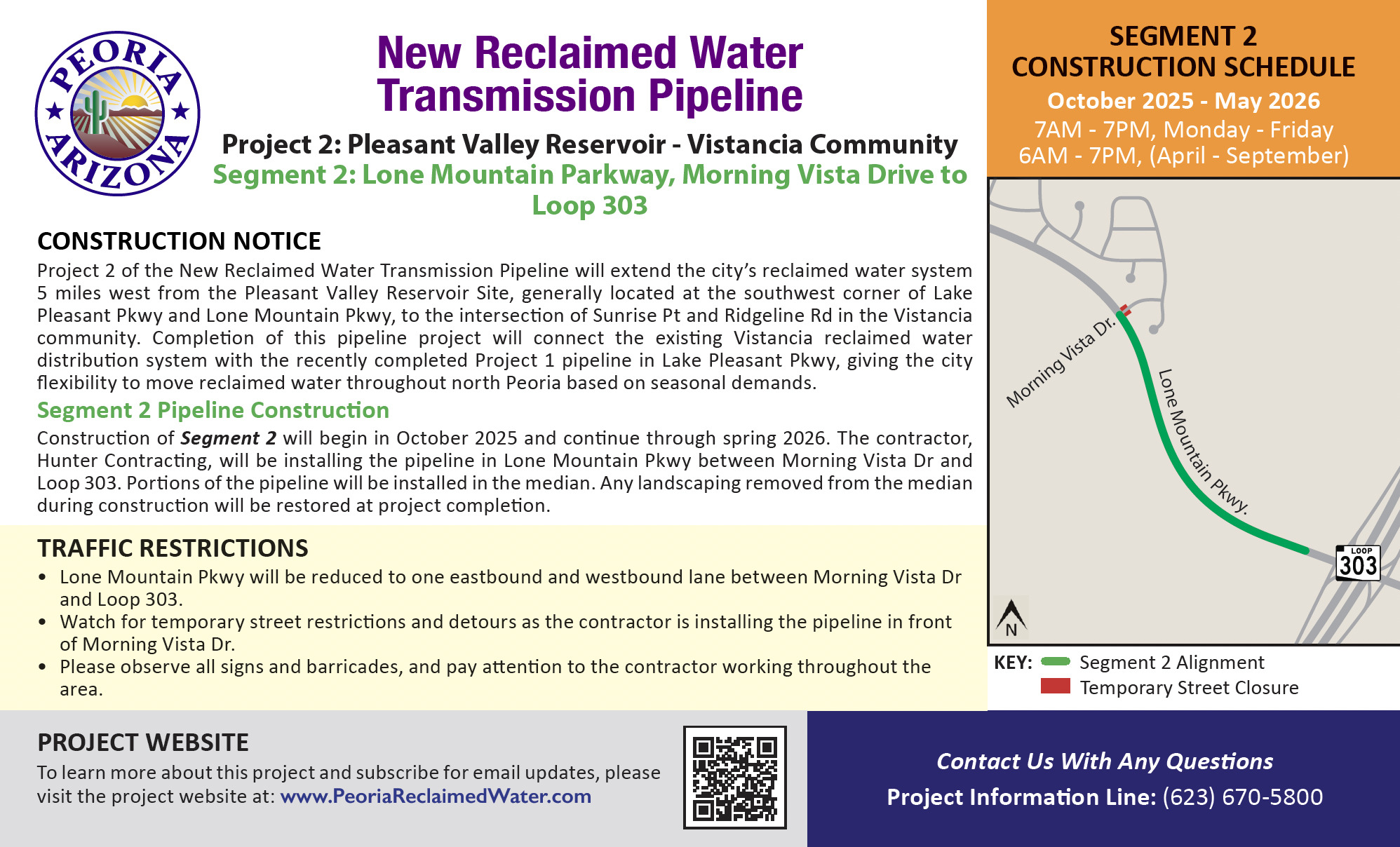

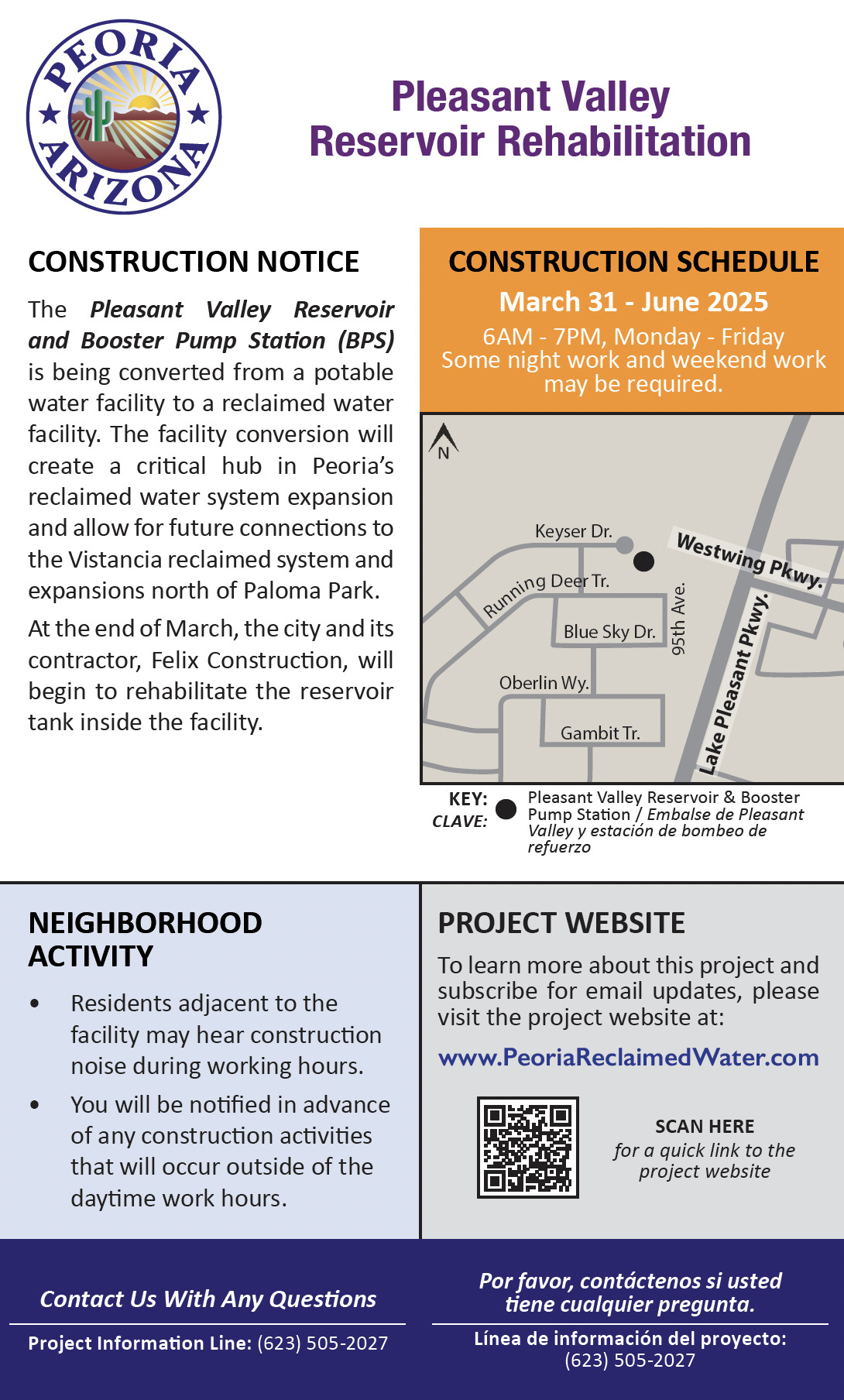

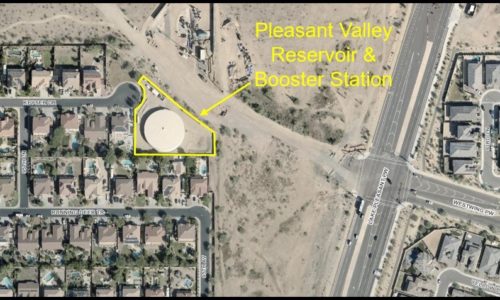

Pleasant Valley Reservoir and Booster Pump Station (BPS) Conversion
The Pleasant Valley Reservoir and BPS is being converted from a potable water facility to a reclaimed water facility. The facility will create a critical hub in the reclaimed water system expansion and allow for future connections to the Vistancia reclaimed system and future expansions north of Paloma Park.
Construction of Phase 1 of the Pleasant Valley Reservoir and BPS Conversion began in March 2024 and concluded in December 2024. Phase 2 will begin at the end of March 2025 and continue through June 2025.
Project Updates
9/25/25
The city of Peoria and its contractor, Hunter Contracting, will begin construction on Segment 2 of the New Reclaimed Water Transmission Pipeline project in October 2025. Construction is anticipated to continue through early 2026. Lone Mountain Parkway will be reduced to one eastbound and westbound lane between Morning Vista Drive and Loop 303 during this time.
If you have any questions, please call the project hotline at: (623) 670-5800.
5/19/2025
The city of Peoria and its contractor, Hunter Contracting, will begin construction of Project 2 Segment 3 of the New Reclaimed Water Transmission Pipeline project in June 2025. Construction is anticipated to continue through early 2026.
The contractor will begin work at the intersection of Sunrise Point and Ridgeline Road and work east to El Mirage Road. Watch for shifting lanes on Ridgeline Road during this time. If you have any questions, please call the project hotline at: (623) 670-5800.
7/26/2024
The City’s contractor has completed construction activities on Segment 3 of the reclaimed water transmission pipeline. The new reclaimed water system is expected to be operational by the end of the year following the completion of the new reclaimed water pump station at Beardsley Water Reclamation Facility and the Pleasant Valley Pump Station Conversion project.
4/3/2024

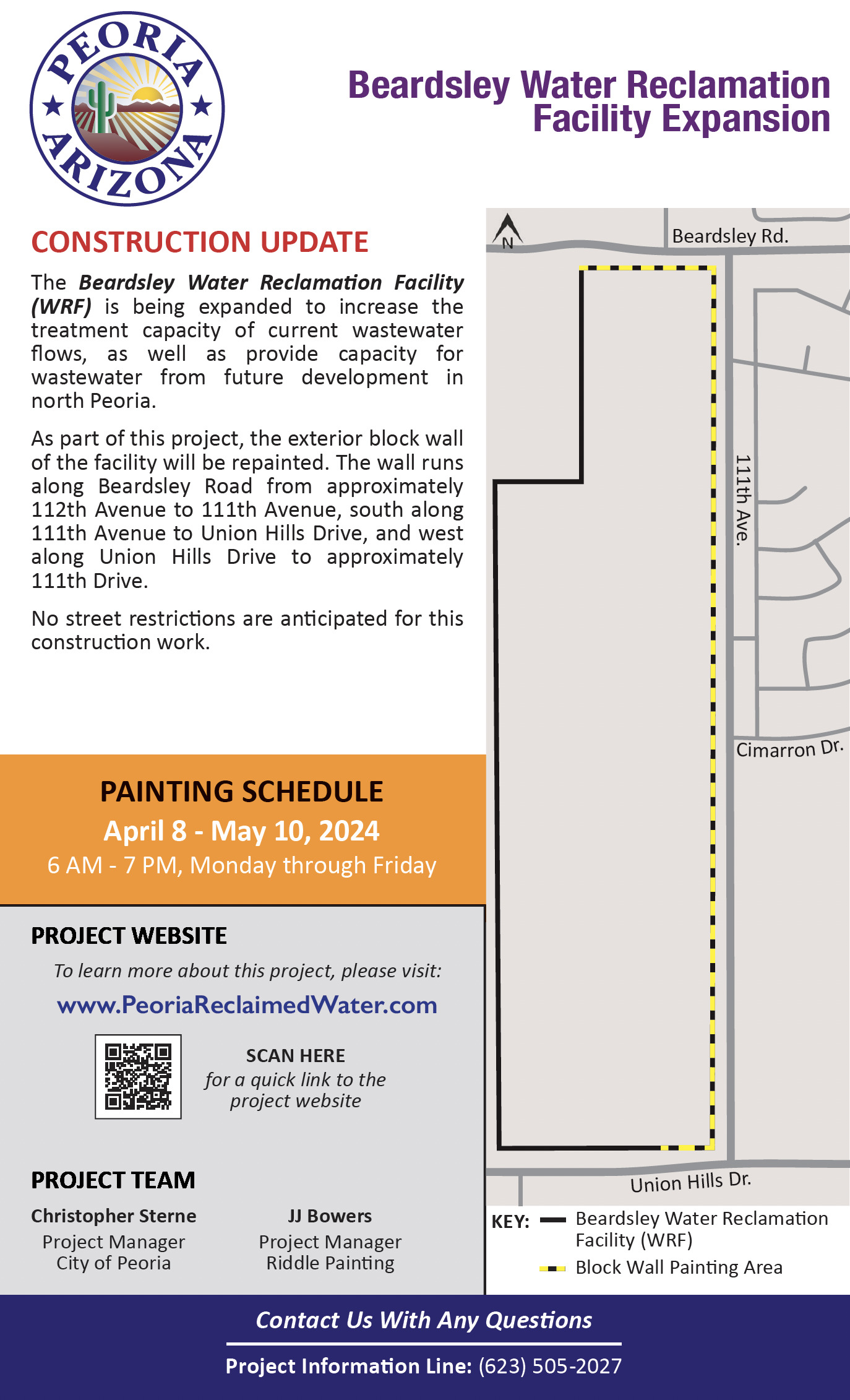

From April 8 to May 10, the exterior block wall of the Beardsley Water Reclamation Facility will be repainted. The wall runs along Beardsley Road from approximately 112th Avenue to 111th Avenue, south along 111th Avenue to Union Hills Drive, and west along Union Hills Drive to approximately 111th Drive. No street restrictions are anticipated for this construction work.
3/13/2024
The Beardsley Water Reclamation Facility Expansion project is ongoing. Upcoming work for an APS service line extension will require a street closure for the safety of the crew and traveling public.

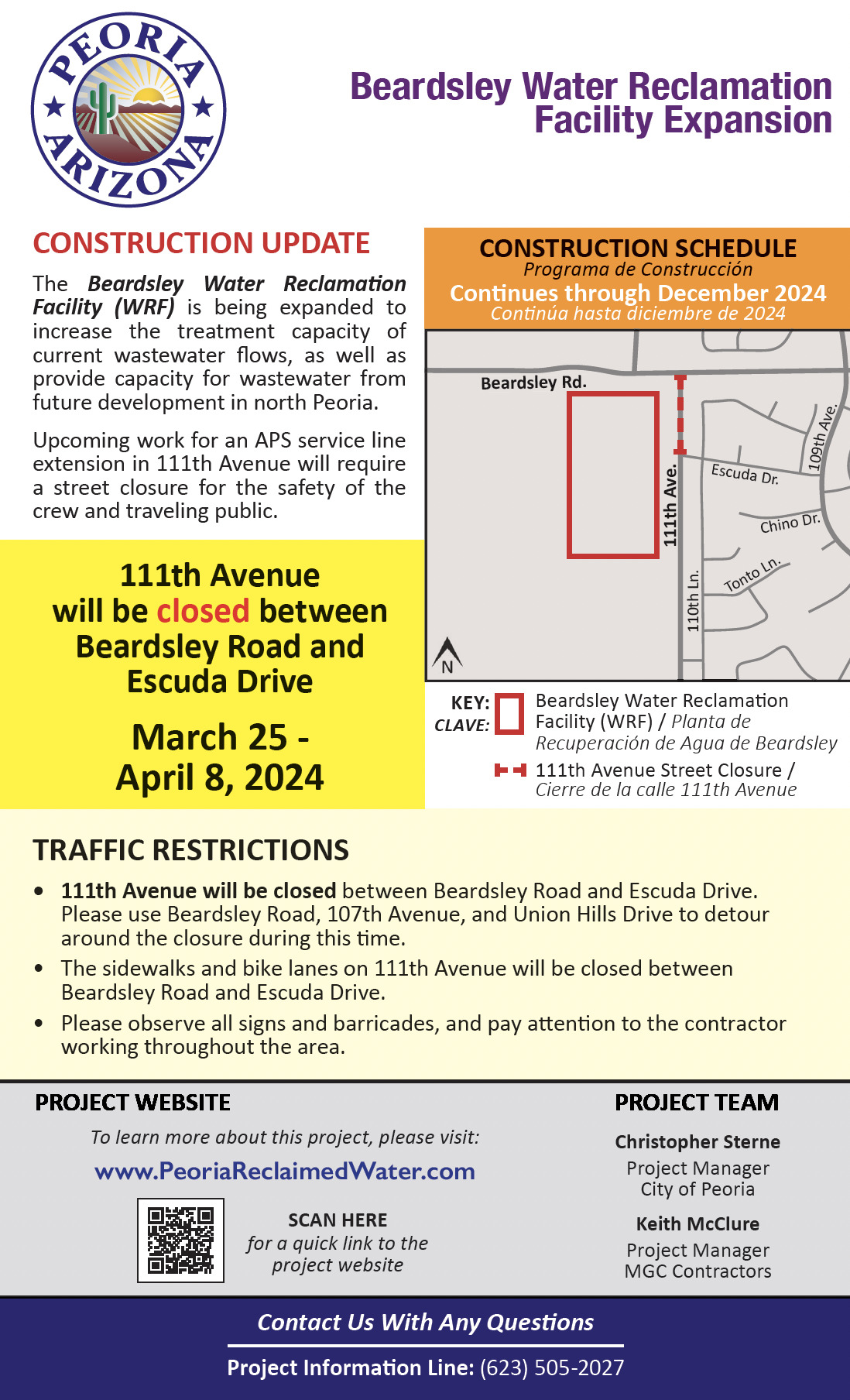

111th Avenue will be closed between Beardsley Road and Escuda Drive from Monday, March 25, to Monday, April 8. The sidewalks and bike lanes in this area will also be closed. Residents should detour around the closure using Beardsley Road, 107th Avenue, and Union Hills Drive.
1/3/2024
The Pleasant Valley Reservoir and Booster Pump Station is being converted from a potable water facility to a reclaimed water facility. Construction will begin in January 2024 and is anticipated to continue through September 2024. Residents adjacent to the facility may hear construction noise during work hours.
11/30/2023
7/10/2023
Construction of Segment 4 of the reclaimed water transmission pipeline is ongoing along Williams Road.
Westbound Williams Road will be closed between 106th Avenue and 107th Avenue from Tuesday, July 18, to Friday, August 4. Please detour around the closure using Deer Valley Road.
5/25/2023
Construction of Segment 3 will begin in June and continue through Summer 2024. The construction notice below was distributed to the community today, May 25. Watch for temporary street restrictions and detours as the contractor is installing the pipeline in front of area streets.
Segment 2 construction is ongoing and will continue through the end of the year.
Segment 4 construction is ongoing and will continue through the end of the year.
2/24/2023

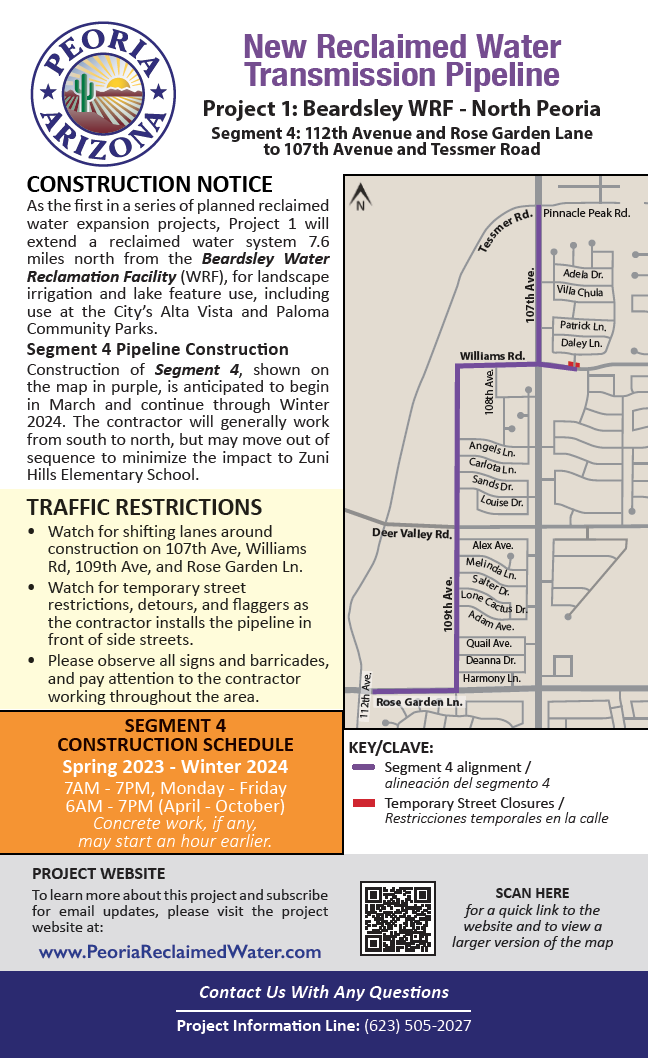

Construction of Segment 4 will begin in March and continue through December. The construction notice below was distributed to the community today, February 24. Watch for temporary lane restrictions, detours, and flaggers as the contractor is installing the pipeline.
Segment 2 construction is ongoing and will continue through the end of the year.
Segment 3 construction is anticipated to begin in summer 2023.
2/3/2023

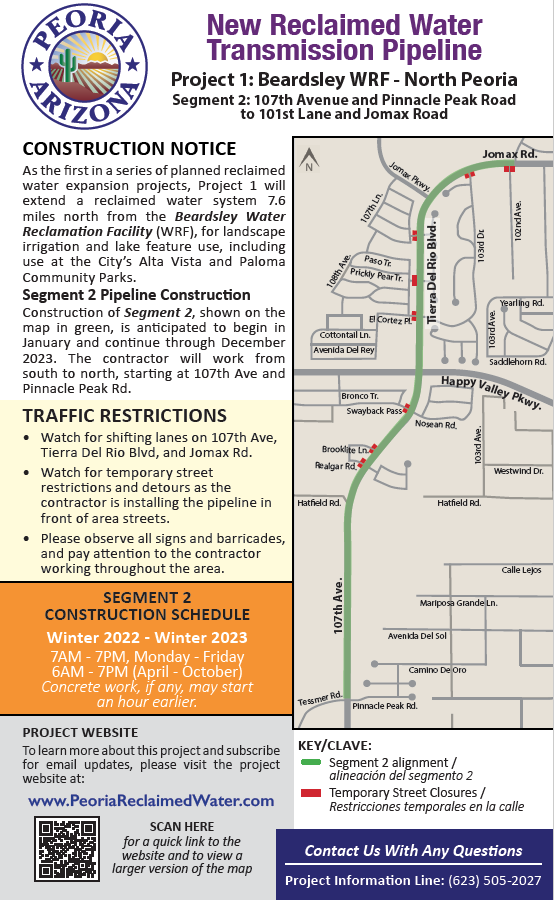

Construction of Segment 2 of the reclaimed water transmission pipeline is underway along 107th Avenue, north of Pinnacle Peak Road. The contractor will be crossing in front of Realgar Road and Brooklite Drive in February.
Realgar Road will be closed from February 13 to 17*. Detour around the closure using Brooklite Drive.
Brooklite Drive will be closed from February 20 to 24*. Detour around the closure using Realgar Road.
*Closure dates may vary slightly due to unanticipated conditions.
To view a map of the upcoming street closures, click here.
12/15/2022
Construction for Segment 2 will begin in early January 2023 and continue through December. The construction notice below was sent out to residences in the area today, December 15. Watch for shifting lanes, temporary street restrictions, and detours as the contractor is installing the pipeline.
Segment 3 construction is anticipated to begin in summer 2023. More information will be provided at a later date.
10/28/2022
The contractor for the Beardsley WRF Expansion will continue installing concrete for the Beardsley WRF on Tuesday, November 1, at 5:00 AM and Wednesday, November 2, at 2:00 AM during the cooler morning hours.
10/11/2022
The contractor for the Beardsley WRF Expansion will continue installing concrete for the new Effluent Pump Station inside the Beardsley WRF on Friday, October 14, beginning at 4:00 AM during cooler temperatures.
10/4/2022
The contractor for the Beardsley WRF Expansion will begin installing concrete for the new Effluent Pump Station inside the Beardsley WRF on Thursday, October 6 at 3:30 AM. It is necessary to begin the concrete work during the cooler morning hours.
6/13/2022
The City’s contractor has completed construction of Segment 1 of the new reclaimed water pipeline. 111th Avenue was reopened for full access on Sunday, May 15th. Please be aware that there may be some minor restrictions while the contractor addresses a few last items.
Segment 2 was solicited for bids and a construction contract with the apparent low bidder will be presented to Council for approval on June 21st. Construction of Segment 2 is expected to begin late fall 2022 and be complete by summer 2023.
Segments 3 and 4 are on track to be bid later this summer.
3/11/2022
Major construction activities have started on the Beardsley WRF Expansion project. Some of these activities may produce higher than normal levels of odor causing gases. Beardsley plant operations staff and the project team are working closely on a daily basis to mitigate odors coming from the facility. If you have concerns about odor at your property, please contact the project team at (623) 505-2027 or info@peoriareclaimedwater.com.
2/22/2022
111th Avenue Closure
1/13/2022
Segment 1 construction will begin next week and you should start seeing construction activity in the area of Beardsley Road and 111th Avenue. Please heed all signs and barricades and pay attention to construction workers in the area.
Also, the second phase of the Beardsley Road pipe evaluation (within pavement) will be starting up and should be complete by the end of the month.
Segments 2, 3, and 4 are on the track for completion of design and we expect to send them individually out for bid starting this spring.
12/15/2021
11/18/2021

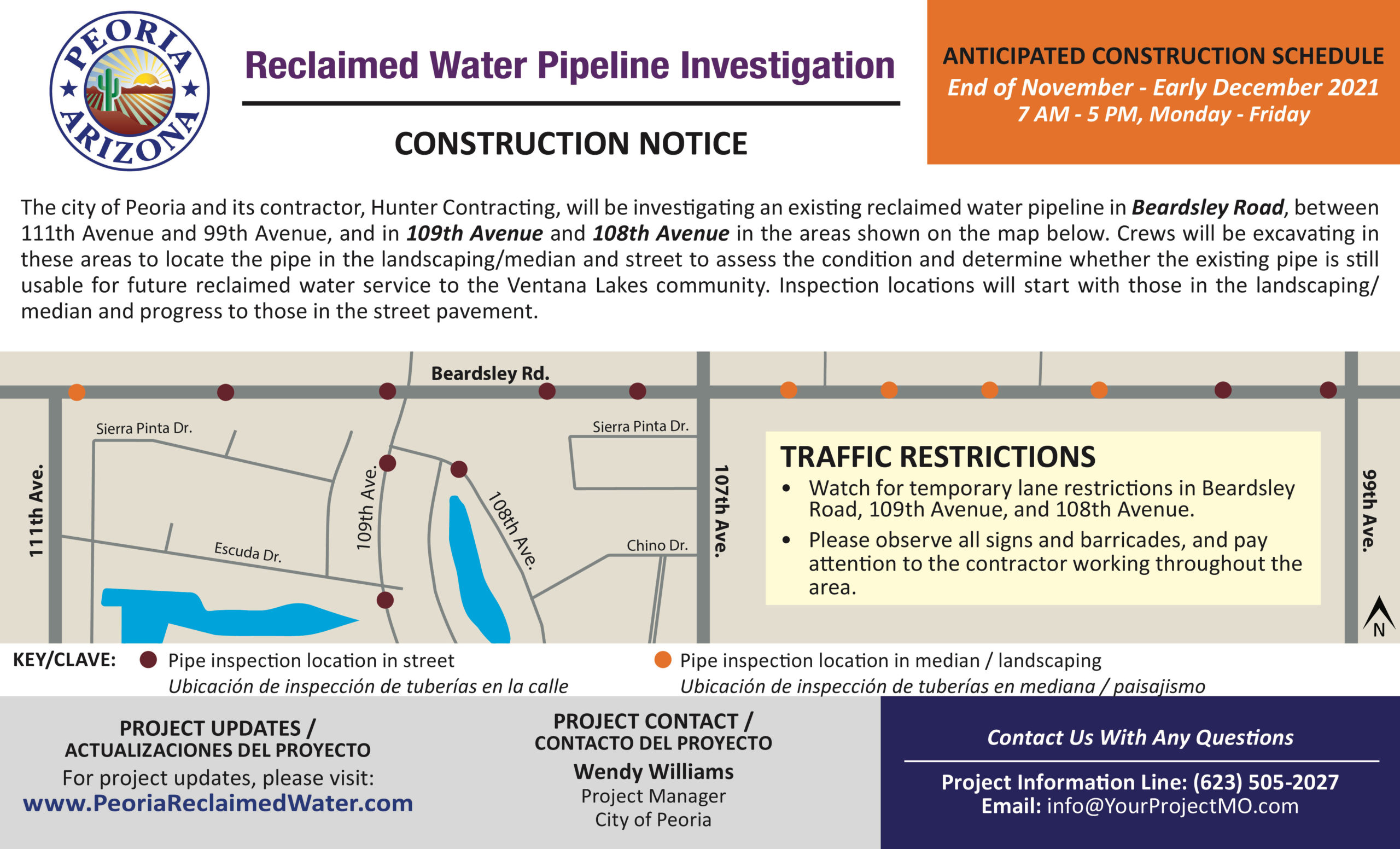

The City’s contractor is preparing to evaluate the viability of the existing reclaimed pipe within Beardsley Road between 111th Avenue and Lake Pleasant Road/99th Avenue. Earlier this week, notices were mailed to properties which border Beardsley Road along this stretch. Please see the notice below for more information.
10/08/2021
At the City’s September 28th Council meeting, a construction contract was approved for the reclaimed pipeline Segment 1 (Beardsley WRF to Rose Garden Ln). Prior to Segment 1 construction, the City’s contractor will begin evaluation of the existing reclaimed waterlines in Beardsley Road and 108th and 109th Avenues. Since this work entails digging into the pipes at several locations to insert a camera, you may see areas of traffic control set up along these roadways for short periods of time. This important investigation will help the City define whether the existing reclaimed pipelines are viable and what repairs may be necessary prior to their use.
Maricopa County has begun construction on a project to extend Deer Valley Road from 109th Avenue west to El Mirage Road. A portion of the City’s Segment 4 reclaimed pipeline is located within the County’s project boundary near the intersection of 109thAvenue and Deer Valley Road. In order to coordinate schedules effectively, the County’s contractor will install the City’s reclaimed pipeline within its project boundary before completing its roadway work in the area. That work should start in Fall 2021 per the County’s current proposed schedule. Later, the City will connect to the piping installed by the County and install the remaining Segment 4 reclaimed piping along the 109th Avenue alignment.
Schedules for all of the work noted above are being finalized and affected residents will receive direct notification(s) as the construction times approach. City staff will post construction notifications and updates to this project website, as well.
In the case of work near 109th Avenue and Deer Valley Road, any notifications will likely come directly from the County. Please contact the County’s Public Information Officer for this project, Bryan Pahia at (602) 506-0543 or Bryan.Pahia@Maricopa.gov for questions or concerns related to the County’s project in this area.
8/31/2021
The City is still moving forward with design of all segments of the reclaimed water pipeline and expects to announce a construction timeline for a few of the locations soon.
7/22/2021
Due to quickly escalating materials costs, the City has temporarily postponed construction of the reclaimed pipeline Segment 1 (Beardsley WRF to Rose Garden Ln) to evaluate cost-saving options. We will post more information as it becomes available and provide everyone with as much notice as possible before construction activities begin.
